Welcome to the settlement journey blog for Early 3191.

We’re Property Settlement Solutions and we’ve been appointed by DM Property  to assist you in your settlement journey.  We will assist in areas such as co-ordinating access for bank valuations, booking your pre-settlement inspection, key collection after settlement and general enquiries.

You can think of us as your settlement concierge; we’re here to help however we can and point you in the right direction with your enquiries.

You’ll hear from us a bit during your settlement journey, and this is page is where updates will be posted. Below we’ll be sharing construction updates & photos, as well as posts letting you know when valuations and purchaser inspections are available. Please also check out our Settlement Guide or our Settlement FAQ for helpful tips to assist you with a smooth settlement.

For your journey Katrina Hope will be your settlement co-ordinator. Please feel free to get in touch with her if you have any questions. Katrina’s contact details are located at the bottom of this page.

SETTLEMENT SNAPSHOT

VALUATIONS

Open for lots 1-16 & 36

PURCHASER INSPECTIONS

Open for lots 1-10

OCCUPANCY CERTIFICATE

Issued for lots 1-10

TITLES

Issued

CALL FOR SETTLEMENT

Lots 1-9 Settlement due on 19th December

LATEST SETTLEMENT UPDATES

December 2024 | Settlement & Construction Update

Welcome to the December update for Early. Please see below for a construction update and updated timings.

Lots 1-10 – Settlement is on 19th December 2024

  • Pre settlement inspections to begin Wednesday 11th December.
  • Information regarding Owners Corporation, Utility connections, moving in procedure and key collection will follow shortly.

Lots 36, 11-16 – Settlement anticipated  for Mid  January 2025

  • Insulation and plaster complete

  • Joinery completed

  • Tiling commenced

  • Painting commenced

Valuations are anticipated to begin before Christmas, we will send you an email to pass onto your lender once your townhouse is ready.



Lots 17-31 –  Settlement anticipated to follow in Mid-End of February 2025

  • Scaffold taken down

  • Services rough in completed

  • Plaster completed

  • Joinery beginning

Lots 32-35 –  Settlement anticipated for early April 2025

  • Roof completed

  • Services rough in completed

  • Plaster beginning

Please see the new photos from site belo

October 2024 | Settlement & Construction Update

Welcome to the October update for Early. Please see below for a construction update and updated timings.

Lots 1-10

  • Plaster completed
  • Joinery being installed
  • Waterproofing completed
  • Tiling beginning

 Settlement is now anticipated for December 2024

Lots 36, 11-16

  • External brick completed
  • Scaffold down
  • Plaster completed
  • Waterproofing commencing

Settlement anticipated  for end of January 2025

Lots 17-31

  • Roof installed
  • Brick façade 80% completed
  • Roof completed
  • Plaster beginning
  •

 Settlement anticipated to follow in end of February 2025

Lots 32-35

  • Frames completed
  • Roof being installed
  • Services rough-in commencing shortly

 Settlement anticipated for early April 2025

September 2024 | Settlement & Construction Update

Welcome to the September update for Early. Please see below for a construction update and scroll down to see the latest site photos

Lots 1-10

  • External brick and roofing completed
  • Scaffold has come down
  • Internal services rough in completed
  • Plaster has begun

Completion is anticipated for Mid December 2024 with settlement anticipated to follow in January 2025

Lots 36, 11-16

  • Framing is completed
  • Roof and windows installed
  • External brick is underway
  • Internal services rough in 70% complete

Completion is anticipated for January 2025 with settlement anticipated to follow in February 2025

Lots 17-31

  • Frames completed
  • Windows installed
  • Scaffold being installed for brick and roof works
  • Internal services rough in beginning

Completion is anticipated for February 2025 with settlement anticipated to follow in March 2025

Lots 32-35

  • Structural steel completed
  • Frame 75% completed

Completion is anticipated for March 2025 with settlement anticipated to follow in April 2025

August 2024 | Settlement & Construction Update

Work is continuing at a steady pace at Early.

Lots 1-10

    • Leading the pack is the George type homes on lots 1-10
    • Roof has been installed
    • Plumbing and electrical rough in has completed
    • Internal plaster to begin shortly

Completion is anticipated for Mid December 2024 with settlement anticipated to follow in January 2025

Lots 11-16 & 36

    • Is closely following behind lots 1-10
    • Frames have now completed
    • Brickwork progressing strongly
    • Window installation beginning

Completion is anticipated for January 2025 with settlement anticipated to follow in February 2025

Lots 17-31

    • Structural steel completed
    • Final level of frames are being erected
    • Windows are being delivered to site

Completion is anticipated for February 2025 with settlement anticipated to follow in March 2025

Lots 32-35

    • Structural steel is completed
    • Ground floor frames are beginning

Completion is anticipated for March 2025 with settlement anticipated to follow in April 2025

TBC- Your Finance Recommendation

Entourage is the recommended broker at Early.

Please contact Damien Roylance if you require any assistance.

M 0421 133 473

E damien@entourage.com.au

Important Settlement Information/ Owners Corporation

Details to be provided closer to settlement.

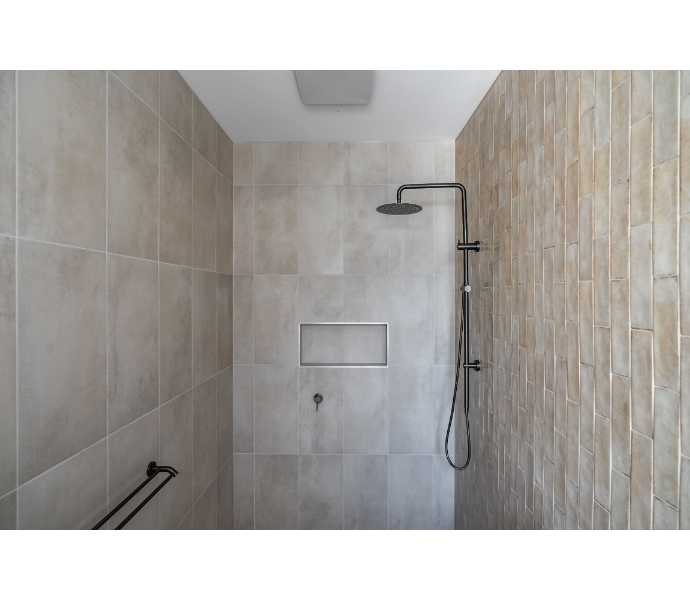

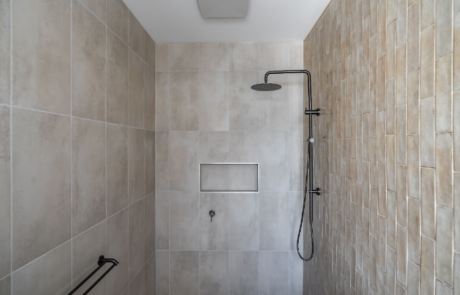

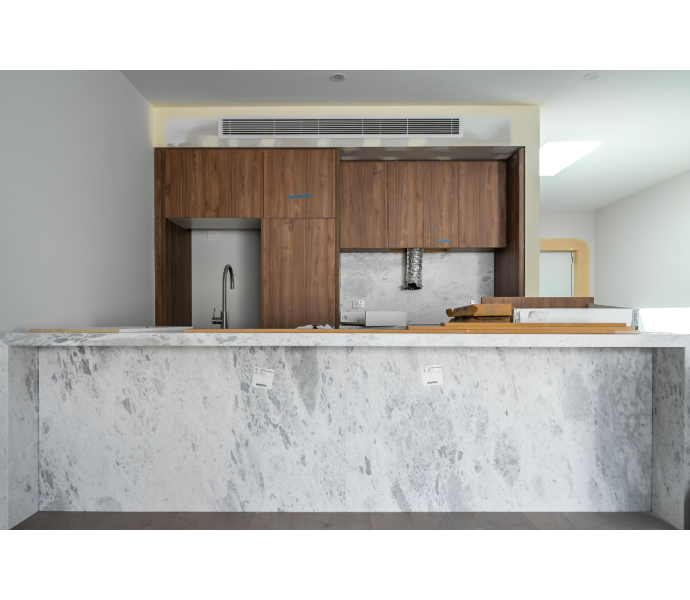

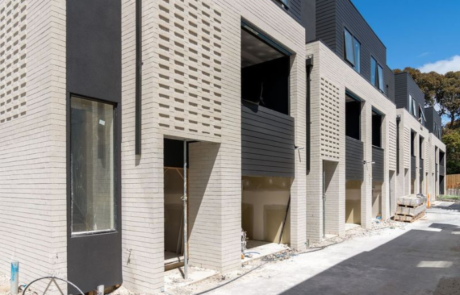

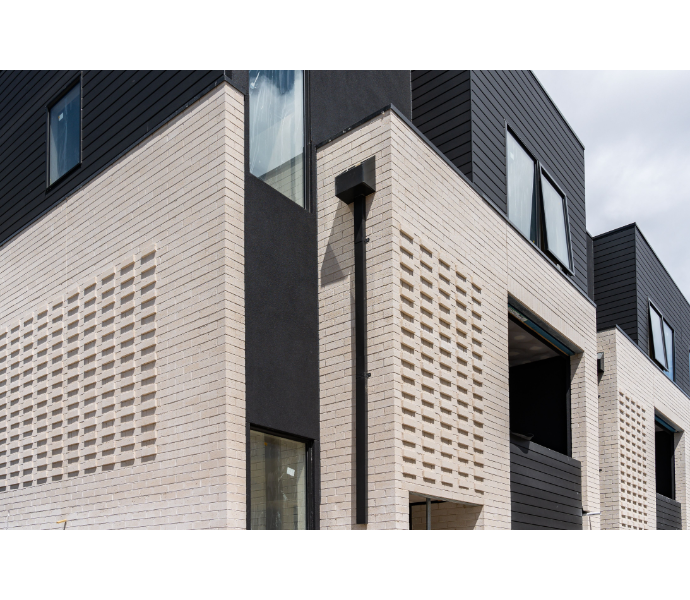

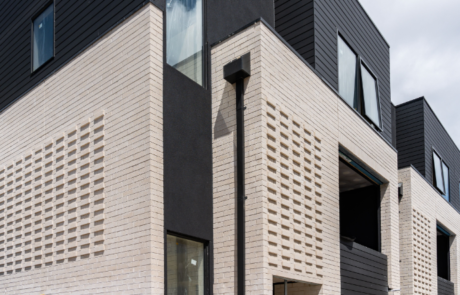

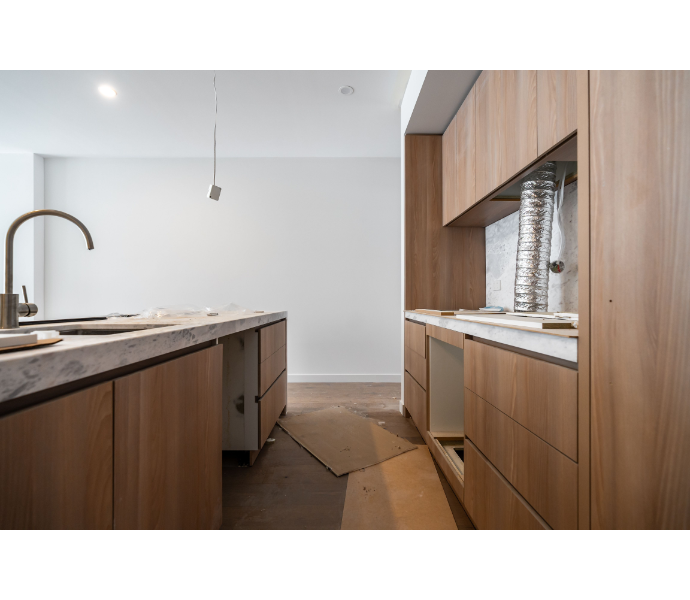

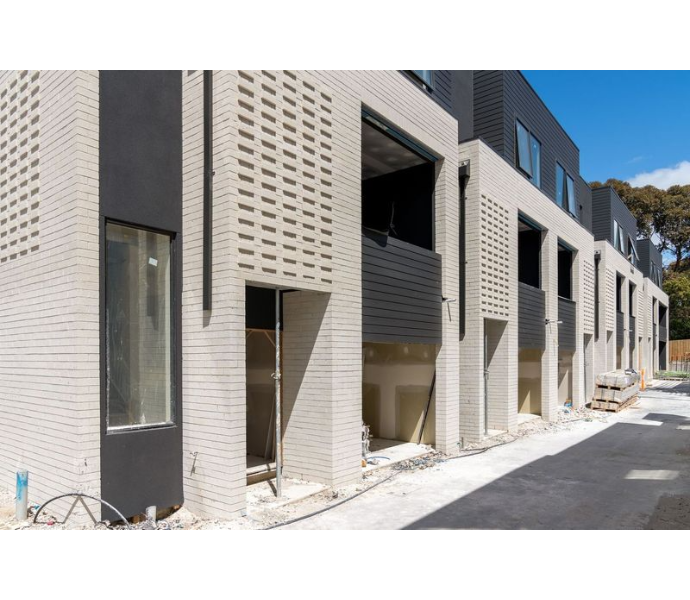

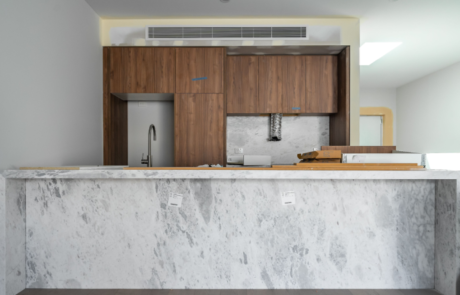

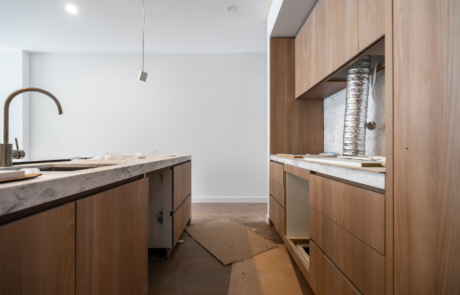

CONSTRUCTION PHOTOS

SETTLEMENT JOURNEY STAGES

CONSIDER FINANCE OPTIONS

At about 3-4 months before settlement you should start to narrow down what financial options you have to settle.

Will you settle by cash, get a home loan, or maybe a combination?

Should you choose to finance with a loan, we recommend you appoint a broker to assist you with your applications.

VALUATIONS BEGIN

We'll let you know once your apartment is ready bank valuations will be available, usually there are required as part of your loan application.

For purchasers bringing money into Australia, make sure you have set up an Australian bank account and begin transferring your money.

PURCHASER INSPECTIONS

At this point construction on your new home is almost complete. We will send you an invite to conduct your pre-settlement inspection.

Any defects picked up in your inspection, will be noted and passed to the builder to begin addressing.

PRE-SETTLEMENT PERIOD

Once your inspection is complete the next stage is to wait for the Occupancy Permit and Titles to be issued so settlement can be called.

Your finance, either cash transfer or Bank loan, should be finalised and ready for settlement.

During this time the builder will continue to address any defects where possible.

SETTLEMENT DAY

Once settlement is called your conveyancer will assist you in preparing for your settlement.

Make sure your loan has been finalised and your cash is ready.

Once your settlement is complete the keys to your new home will be available to collect.

POST SETTLEMENT

Your settlement has been finalised.

We'll pass on details of the move in process and helpful information so you can get ready for your new home.

Your dedicated Owners corporation/ building manager will now be your point of contact & assist you with settling in to your new home.

SETTLEMENT RESOURCES

YOUR SETTLEMENT CO-ORDINATOR

Katrina Hope
Senior Project Manager

katrina@settlement-solutions.com.au
+61 493 098 241

Proudly presented by

Logo for Charlie and blog.
COPYRIGHT PROPERTY SETTLEMENT SOLUTIONS 2022
ALL RIGHTS RESERVED
WWW.SETTLEMENT-SOLUTIONS.COM.AU
PSSsmall
